Peninsula Road

Planning for Change
Planning for Change
This project is a significant opportunity for our community – it is also a significant change. Change comes will challenges. By working together as a community to identify concerns and challenges we can proactively plan for how to reduce and mitigate impacts. To be successful, we will need to work as a community to come to balanced and realistic solutions. The District and project team is committed to transparency through this important community project and process.
Community & Stakeholder Engagement
Community & Stakeholder Engagement
A key part of the project is continuing to engage with the community, stakeholders, and interest groups to maintain the District’s commitment to review and feedback opportunities. While we know this project will bring many positive benefits to our community once complete, we also recognize that the road changes and construction process will affect all of those who live, work, or visit our community.
We also acknowledge that the project changes and construction will most affect the property owners/business/owners/tenants directly on Peninsula Road. The team will work together to answer how the proposed design responds to challenges, and to plan how we best manage and reduce the impacts of the construction process.
Please check back here for project updates and for opportunities to share your input and comments.
Project Background
Project Background
Improving Peninsula Road has been a topic of community interest for many years. Driven by community input, the revitalization of the project area has become a priority for the District. Preliminary analysis and design ideas were developed in the 2019 Peninsula Road Streetscape Study and process. The 2019 study reviewed ideas and challenges for the area along with options for enhancing safety, mobility, character, and community values. Community review and feedback from the December 2019 open house shaped the project foundation and key design directions.
The project’s aims and terms were then refined through the 2019-2022 Strategic Plan and the policies within the District of Ucluelet’s 2020 Official Community Plan (adopted January, 2022). Based on these community inputs and plans, a Conceptual Design package was developed in 2021 to support a grant funding application. Prior to detailed design development, the first step that kicked off this project was community and stakeholder engagement to gain feedback on the existing Concept Design.
Why Now?
Why Now?
The first phase of this project is possible since the District has secured grant funding, and the Ministry of Transportation and Infrastructure (MOTI) is supporting the storm system replacement and collaborating to align their re-paving of Peninsula Road. Without these opportunities, the District would not be able to fund the Phase 1 scope at present. The alignment of these opportunities is time-sensitive and specific to 2023/2024.

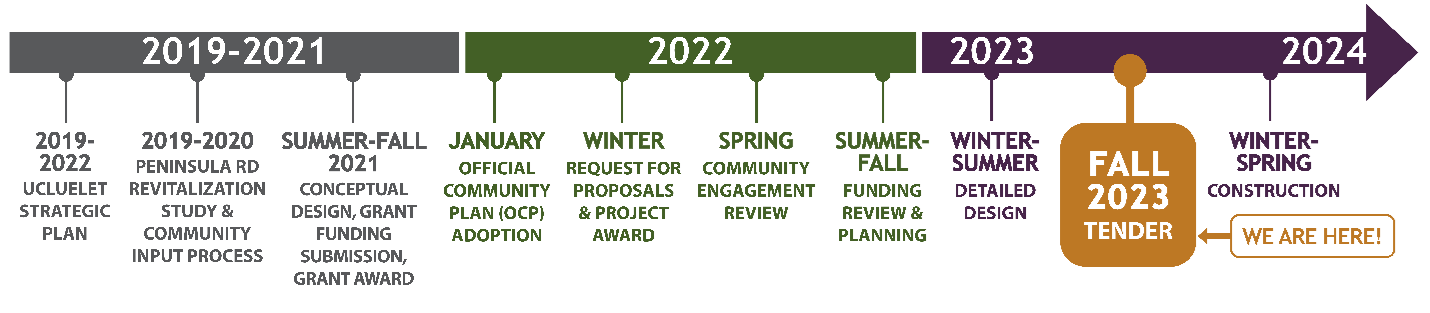

Project Timeline
Project Timeline

Relevant Policies & Approvals
Relevant Policies & Approvals
- OCP Direction: The Official Community Plan (adopted January 2022) identifies Peninsula Road as the gateway and main approach into Ucluelet, a focal point for the District’s image and streetscape character, and a priority for accessibility and active transportation (pedestrian, cycle, and transit service). This document provides the overall guidance for the terms and aims of this project.
- MOTI Jurisdiction: The portion of Peninsula Road north of Main Street is under the jurisdiction of the BC Ministry of Transportation & Infrastructure (MOTI). Planning and design of this portion of Peninsula Road will require coordination and ultimately approval from the MOTI.
- District of Ucluelet Mayor & Council: The District of Ucluelet Council reviewed and approved the project terms and award. Council will be involved in milestone reviews through detailed design development as well as the tender award recommendation for construction.
Design Features & Objectives
Design Features & Objectives
The previous efforts have outlined key design criteria to be addressed in the detailed design, including, but not limited to:
Accessibility: Improve the accessibility of existing crosswalks, sidewalks, and pathways, including adding additional crossings and paths on the northside of the road.
Cycling: Develop protected one-way cycle paths in both directions, including improvements to the existing path on the south side. Prioritize separation of the cycle path from vehicle travel lanes to support all ages and abilities (AAA).
Pedestrians: Improve walkability including improving sidewalks or paths on the south side and adding or improving pedestrian routes on the north side of Peninsula Road where possible.
Traffic Calming: Provide improved safety and a calmed traffic speed that transitions from the highway condition arriving from the northwest. Include curbing extensions at intersections and crosswalks to support traffic calming and provide safety and comfort for pedestrians and cyclists.
Intersections: Define intersections that balance the needs of pedestrians, cyclists, and vehicles. Provide curbing extensions for shortened and protected crossings for pedestrians and cyclists.

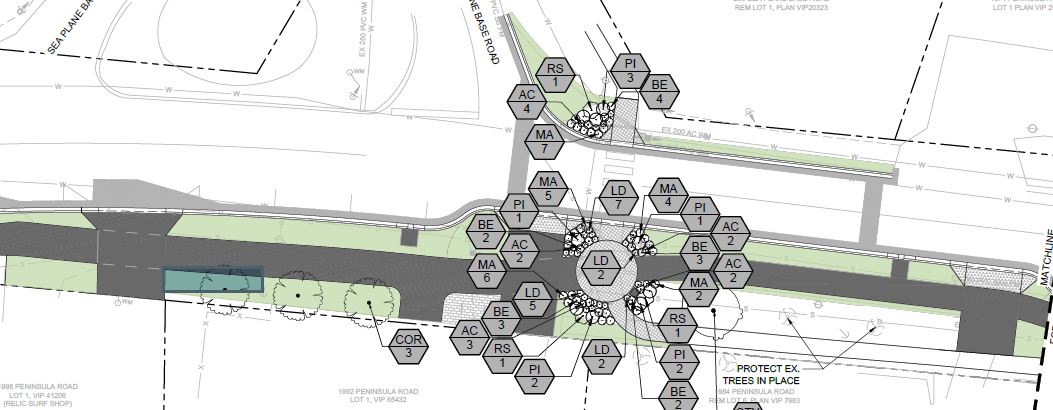

Character & Aesthetics: Go beyond “standard” highway design to enhance the travel experience and character to enhance the unique of Ucluelet. The design approach should build on Ucluelet’s distinct identity and character through furnishings, vegetation, hard landscape materials, and public art opportunities. Where this effort is not possible to address in initial phases it should be addressed with future upgrades.
Landscape & Maintenance: Trees, vegetation, and landscape features should support the safety of movement in the streetscape while contributing to the local sense of place. The landscape should enhance the character and comfort of the street while balancing practical, low maintenance needs. Principles of sustainability, water infiltration, and use of native and adaptive species should be used in planting and landscape design.
Click the links below for more information:

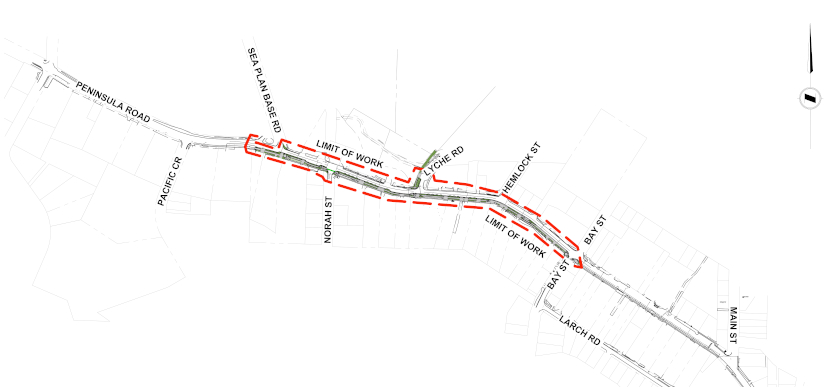

Peninsula Road Repaving Improvements (Phase 1)

November 28, 2024 – Completion of Phase 1 of the Project
District of Ucluelet Announces Completion of Phase 1 of the Peninsula Road Safety & Revitalization Project.
Read Press Release here:
October 22, 2024 – Line Painting
Please be advised that Fineline Road Marking, working on the behalf of Hazelwood Construction Services & the District of Ucluelet, will be completing road line marking tomorrow October 22, 2024 in the newly paved section between Bay Street and Main Street.
Read full Community Notice here: Notice – Peninsula Road Safety & Revitalization Project Line Painting October 22, 2024 (ucluelet.ca)
Section 3 Paving Plan Drawings
Repaving Improvements Construction Updates
Updates for the Week of October 7, 2024 provided by McElhanney Engineering Company:
The repaving improvements of Peninsula Road between Bay Street and Main Street commenced the week of September 23, 2024. The following are the construction update and notice provided by Hazelwood Construction Services Inc., working on behalf of the District of Ucluelet.
